Modular Building Installation
Build on Reliability
Installation is where months of factory work become a building on your site. In commercial modular construction, it’s also the phase with the least room for error, so we plan every set before the first module leaves the plant.
Safety and efficiency are paramount. Installation of the modular units is meticulously choreographed to make efficient use of crane/crew time. Site logistics plans are developed to ensure all of the moving parts (crane, man lifts, modular units, transport carries, dumpsters, etc.) have adequate dedicated areas to perform the entire operation.
How a Commercial Modular Set Comes Together
- Site logistics plan. Crane location, module staging, man lifts, delivery routes, and dumpster placement are mapped in advance, so each piece of equipment has a dedicated area.
- Delivery in set order. Ritz-Trans, RC²'s logistics partner, analyzes routes, secures permits, and delivers modules staged in the order they will be set, so the crew can start work right away.
- Crane set. A high-capacity crane lifts each module into position on the foundation or onto the modules below it.
- Structural attachment. Each module is secured to the foundation and to the adjoining units. Weather-in. The building is protected from the elements as the set progresses.
- Handoff. Once RC²'s scope is complete, the on-site trades finish the remaining work.

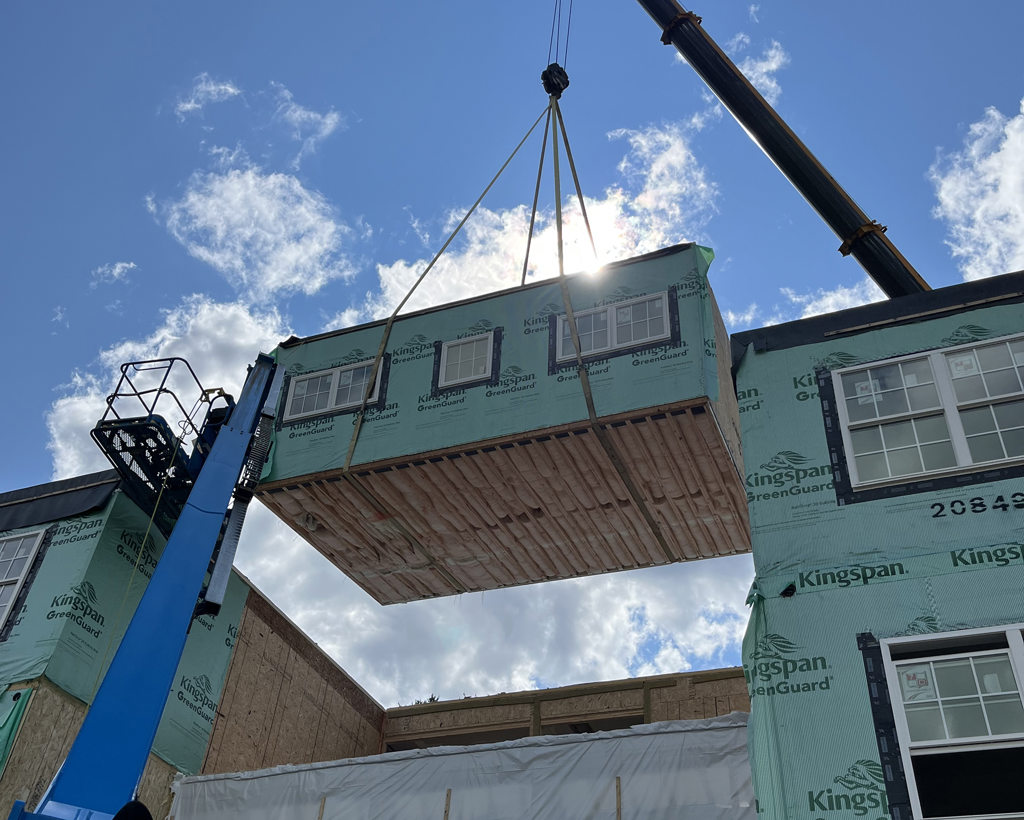

Precise Positioning
We take great care in ensuring precise placement and secure structural attachment to both the foundation and other units.
Our dedicated team manages the crew, crane, and all necessary equipment to support a seamless installation, leaving no room for guesswork or unexpected complications.

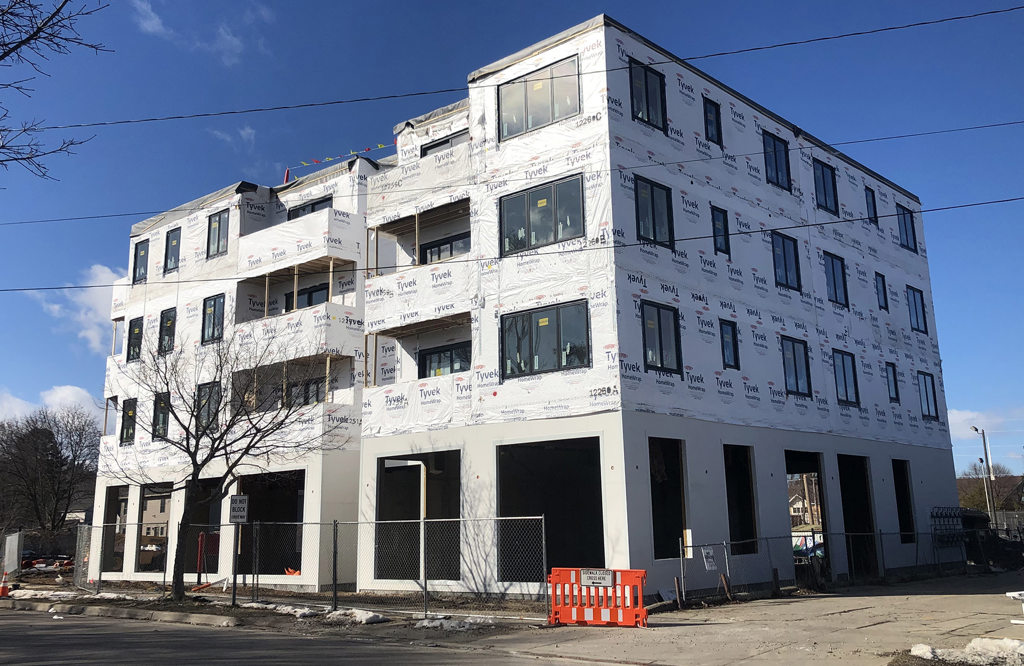

Weatherproof Assurance
We take the necessary measures to protect your investment from the elements, safeguarding the integrity of the structure and preserving the quality of your modular buildings.
Because modules are finished indoors and weathered in during the set, the structure spends far less time exposed. Traditional stick-built construction can take months to weather in.
Final Completion Made Easier
Upon RC2 completing its scope installing, securing, and weather-proofing the building; the on-site trades can complete the remaining work.
Since the project was designed in accordance with RC2 building technology, achieving final completion is easier and much quicker than conventional construction means and methods.
Why Installation Planning Protects Your Schedule and Budget
Crane and crew hours are among the most expensive on a modular project. A detailed logistics plan keeps that time productive and gives the general contractor a clear window for foundations, utilities, and follow-on trades. The result is a set that runs to plan and a closeout the whole team can schedule with confidence.
Installation FAQs
RC² manages the crew, crane, and equipment needed for installation.
The site contractor prepares the foundation while modules are built in the plant, then completes the remaining work after RC² finishes installing, securing, and weatherproofing the building.
Yes. At Ocean Green Senior Apartments in Jersey City, there was no on-site storage, and street closures were limited. RC² placed a crane pad inside the building footprint, staged units at off-site storage four blocks away, and completed the second phase of 16 units with a two-day lane closure.
